The Fort Washington Flood Risk Mitigation and Stormwater Management Project is being implemented by Prince George’s County Department of Environment and GV-Petro Joint Venture, LLC (a partnership between GreenVest and Petro Design Build Group). The Project aims to provide sediment and nutrient reduction to the County and address nuisance flooding and erosion that has negatively affected residents of the Tantallon community.
The Project will retrofit or create ±8 stormwater management facilities and stabilize ±4,174 linear feet of stream with the goal to reduce pollutants and address the causes of frequent flooding and increase community resiliency to storm events.
The Project will be implemented in three discrete stages to limit disturbances to the Tantallon community and golf course operations. The Project is currently undergoing design and permitting, with construction commencement expected in Fall 2026. An anticipated project timeline can be found below and will be updated by the Project Team to reflect any changes as the Project advances.
Video pipe inspection was completed in order to characterize the health of the community storm drain system.
Please contact the Project Team with any questions or concerns at FtWashington@GreenVestUS.com.

Meet your Fort Washington Team:
Max Breslin, Senior Project Manager, GreenVest
Patrick Phillips, Vice President, GreenVest
Kathleen Litchfield, President, Petro Design Build Group

Meet your Prince George’s County Contacts:
Jeff DeHan, Associate Director, Stormwater Management Division, Department of the Environment, jmdehan@co.pg.md.us
Edward Burroughs, III, Chair, County Council District 8

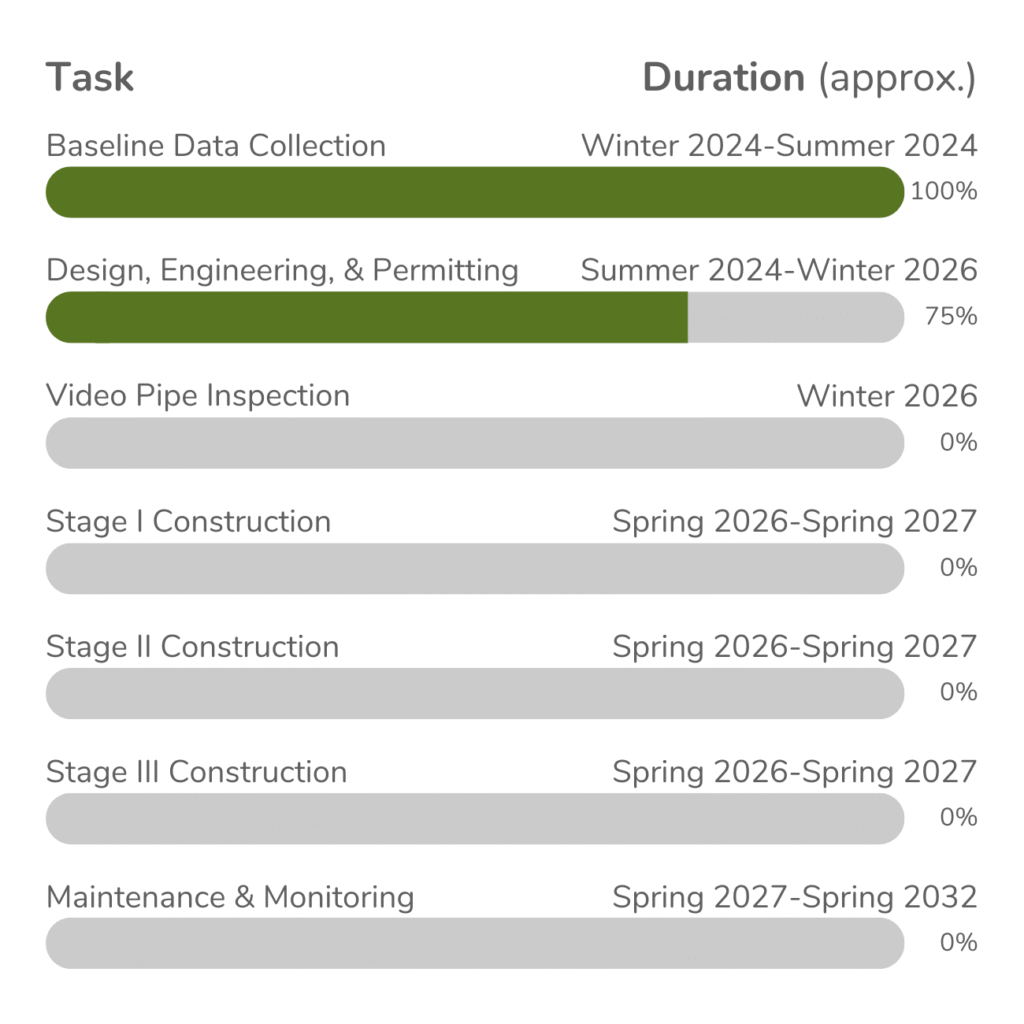

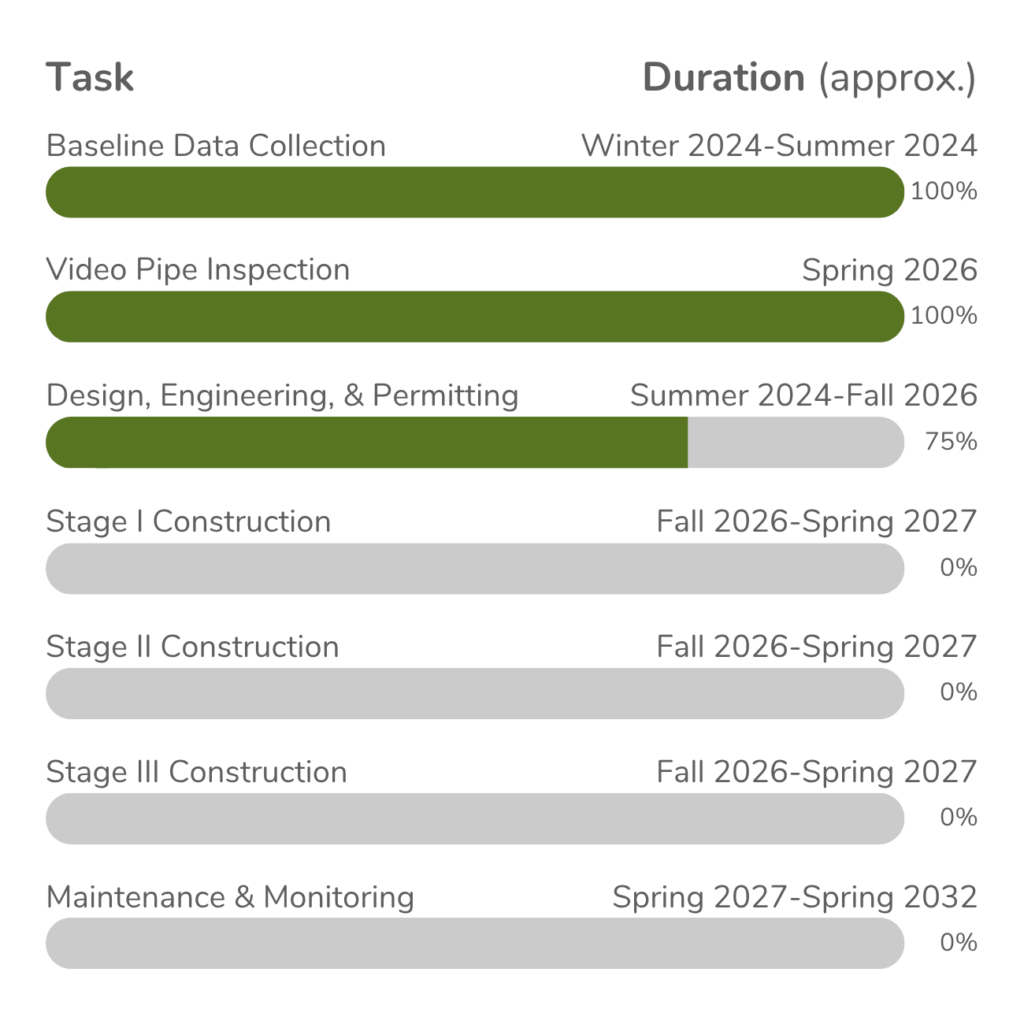

Project Schedule: last updated July 13, 2026
